A methane barrier is a gas-impermeable membrane system installed beneath a building's slab and against below-grade walls to keep methane gas from migrating out of the soil and into occupied space. The barrier is one part of a larger methane mitigation system that also includes a gravel vent layer, perforated collection piping, vent risers, and in some cases mechanical blowers and gas alarms. If your parcel sits in a designated methane zone, most prominently in the City of Los Angeles, the building department will not let you pour a slab until an engineered mitigation system is designed, installed, inspected, and certified.
Why methane intrusion is dangerous
Methane is generated in the subsurface wherever organic material decomposes, and it is common near historic oil fields, landfills, disposal sites, and petroleum-contaminated soils. The gas itself is colorless and odorless, and it is combustible in air at concentrations between roughly 5 percent and 15 percent by volume. That lower flammability limit of 5 percent, equal to 50,000 parts per million by volume, is the benchmark regulators use: soil gas readings are typically expressed as a fraction of the lower explosive limit, and mitigation requirements ramp up as concentrations climb toward it.
The risk is not theoretical. On March 24, 1985, methane that had accumulated beneath a Ross Dress for Less store in the Fairfax district of Los Angeles ignited, injuring more than 20 people and blowing out the storefront. That explosion is the direct reason Los Angeles mapped its methane zones and built one of the most detailed methane mitigation codes in the country. Buildings constructed over gas-bearing soils without a barrier can accumulate methane in wall cavities, crawl spaces, elevator pits, and utility rooms, exactly the confined spaces where an ignition source does the most damage.
How to find out if your parcel is in a methane zone
In the City of Los Angeles, methane requirements are enforced by the Los Angeles Department of Building and Safety (LADBS) under Division 71 of the Los Angeles Municipal Code. The city maintains an official map that classifies parcels into two categories: the Methane Zone, generally covering historic oil fields, landfills, and known gas-bearing formations, and the Methane Buffer Zone surrounding it. You can check any address through the city's ZIMAS parcel lookup, and any project team working in central Los Angeles, the Fairfax district, Playa del Rey, or the harbor area should check early because the zones cover large portions of the city.
Being mapped in a zone does not by itself dictate the mitigation system. It triggers a soil gas investigation: a geotechnical or environmental consultant installs shallow and deep soil gas probes across the site and measures two things, the methane concentration in parts per million by volume and the subsurface gas pressure. Those two readings determine the Site Design Level, which in turn dictates every component the mitigation system must include.
Site Design Levels: the numbers that drive the design
LADBS assigns each site a design level from I through V based on the highest methane concentration found and whether subslab gas pressure meets or exceeds 2 inches of water column. The concentration breakpoints step up from 100 ppmv at the low end to 12,500 ppmv, which is 25 percent of methane's lower explosive limit, at the top. A site testing below 100 ppmv with low pressure lands at Level I and needs only basic measures, while a site above 12,500 ppmv lands at Level V and requires the full system: an impervious membrane, a subslab vent layer with collection piping, vent risers, and active components such as mechanical extraction and gas detection.
- Design Levels I and II (lower concentrations): passive protection, typically a de-watering system where groundwater is shallow, a vent gravel layer, and an under-slab membrane at the higher of the two levels.
- Design Levels III and IV (mid-range concentrations or elevated pressure): full passive systems with an impervious membrane, perforated horizontal collection pipes in the gravel blanket, and vent risers carrying gas above the roofline.
- Design Level V (above 12,500 ppmv, 25 percent of the LEL): everything above plus active mitigation, which can include mechanical blowers, methane sensors, alarm panels, and ventilation interlocks in enclosed spaces.
The practical takeaway for a developer or architect: the soil gas report is the controlling document. Until the probes are read, nobody can tell you whether your project needs a simple membrane or a fully alarmed active system, and the difference between those two scopes is significant in both cost and schedule.
What the barrier system consists of
The membrane is the heart of the system, and four families of material dominate methane mitigation work. Each is installed over a prepared subgrade and vent layer and finished as a continuous gas-tight sheet with every pipe and structural penetration individually sealed.
- HDPE and LLDPE sheet membranes: polyethylene geomembranes deployed in rolls and heat-welded into a continuous barrier. Sheet barriers in methane service commonly run 40 to 60 mil thick, and welded seams can be air-channel or vacuum tested for integrity.
- PVC membranes: flexible sheet systems that conform well to complex slab geometry and are chemically welded or heat-welded at seams.
- Spray-applied liquid boot systems: an asphaltic or polymer membrane spray-applied over a geotextile carrier, curing into a seamless barrier, typically specified at a 60 mil dry film thickness. Because there are no factory seams, liquid systems excel at grade beams, footings, pile caps, and irregular penetrations.
- Composite absolute barrier products: multi-ply membranes that laminate plastic sheet with metallized film to achieve the lowest gas permeance available, used on sites with elevated design levels or particularly aggressive gas readings.
Below the membrane sits the vent layer, usually a gravel blanket with perforated collection piping that gives migrating gas an easier path than the building above. Risers carry collected gas up the structure and discharge it above the roof, where it dilutes harmlessly. On active systems, blowers pull a slight vacuum on the vent layer so gas never builds pressure against the membrane at all.
The LADBS approval and inspection process
Methane mitigation in Los Angeles follows a defined sequence, and the barrier installer is only one player in it. A typical project moves through five stages.
- Soil gas investigation: probes are installed and sampled, and the consultant's report establishes the methane concentration, pressure, and resulting Site Design Level.
- Mitigation design: the methane mitigation engineer of record designs the system to the assigned design level and submits plans to LADBS for approval before construction.
- Installation: the barrier contractor places the vent layer and membrane, seams or sprays it into a continuous layer, seals every penetration, and protects the finished barrier from damage by following trades.
- Inspection and testing: a certified Deputy Inspector observes the installation, witnesses seam and integrity testing, and verifies the membrane against the approved plans before anything covers it.
- Certification and slab pour: only after the Deputy Inspector signs off can concrete be placed over the barrier. Cover the membrane early and you will be pulling slab back out to prove compliance.
The Deputy Inspector role deserves emphasis because it surprises teams new to methane work. This is not a standard city building inspection. LADBS requires continuous special inspection of the barrier installation by a Deputy Inspector certified for methane mitigation, and the inspector's certification is what closes out the methane requirement on the permit. An experienced installation crew coordinates with the Deputy Inspector throughout the installation, not just at the end, so seam tests, boot details, and repairs are witnessed as they happen and the barrier passes the first time.
Who installs the barrier, and does building type matter?
Barrier installation is specialty work: the materials are geosynthetics, the seaming is thermal or spray welding, and the acceptance testing mirrors what geomembrane crews do on ponds and landfills. EC Applications installs all four barrier families, HDPE and LLDPE sheet, PVC, spray-applied liquid boot, and composite absolute barrier systems, for both commercial buildings and residential homes, with every installation built to LADBS compliance and certified through Deputy Inspector coordination. The company holds California contractor licenses CSLB #894068 and #1003207 and self-performs this work from its Anaheim headquarters across the Los Angeles area's methane zones.

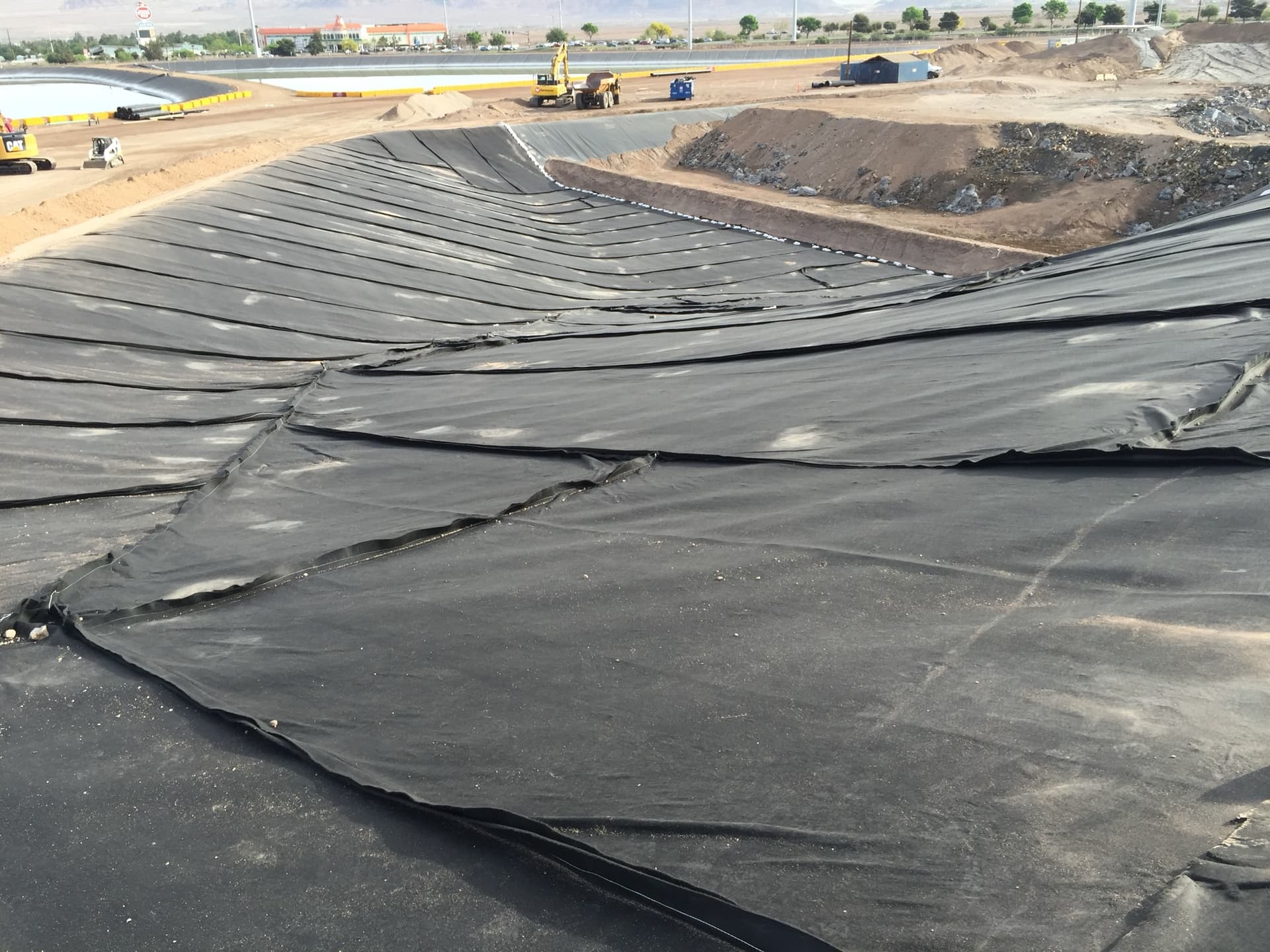

The same membrane skill set scales well beyond the building pad. One of the larger methane containment installations in EC Applications' project history was built for Hawaiian Electric Company: a 600,000 square foot biogas cover and passive methane barrier installed over an existing lagoon in multiple phases, using 45 mil XR-5 geosynthetic liner over 12 ounce geotextile with roughly 1,000 linear feet of stainless-steel mechanical attachment. The installation sealed more than 150 penetrations, and every seam was vacuum tested with the completed system smoke tested to confirm it was leak-proof. The lesson transfers directly to under-slab work: penetrations and seams are where barriers fail, so penetrations and seams are where the testing effort belongs.
What it means for your schedule
Plan for the methane process in calendar terms, not just dollars. The soil gas investigation and LADBS plan approval happen before the barrier contractor ever mobilizes, so teams that discover the methane zone designation late often lose weeks waiting on probe data and design review. The membrane installation itself is fast relative to the rest of the sequence, typically measured in days for a routine building pad, but it sits on the critical path immediately ahead of the slab pour and cannot be closed out until the Deputy Inspector certifies it. The reliable way to protect the schedule is to run the soil investigation during due diligence, get the mitigation design into LADBS early, and bring the barrier installer into coordination before the foundation package is finalized.
